On Tuesday, July 23rd, 2024, an RFQ for the 6-24 Runway Reconstruction project was issued. The 6-24 Runway Reconstruction RFQ was posted on the Georgia Procurement website and sent out to thousands of companies. An optional pre-bid conference was held on August 8th, 2024, with all bids due on August 29, 2024. We received six bids, one for asphalt and five for concrete, ranging from $22.23-$37.96 million.
The project will be funded through FAA and GDOT grants, airport sponsors are required to select the lowest bidder, if all the other requirements listed in the bid package are met. Summers Concrete Contracting, Inc. was the lowest bidder with a total project cost of $22,229,455.16. Bid information was sent to FAA and GDOT for verification, all other requirements including Disadvantaged Business Enterprise (DBE) requirements were met by the lowest bidder.

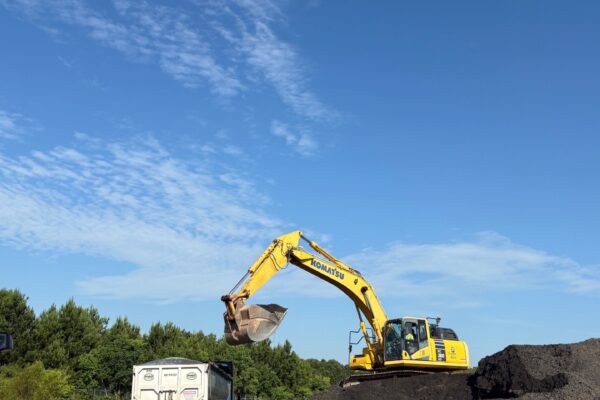

The contract was approved to Summers Concrete Contracting, Inc at the October 1st Commission Meeting. Both the federal and state grants have been executed and issued for this project and the contractor has begun acquiring supplies and equipment. Construction is scheduled to begin August 5, 2025 and is estimated to last through November 27, 2025.

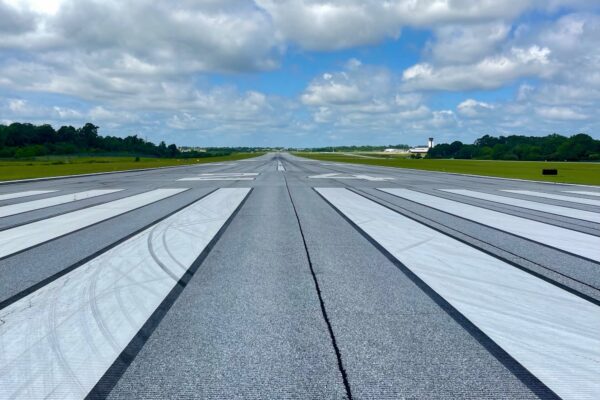

CSG Runway 6/24 Project is a runway reconstruction project totaling an estimated $24 million to fully reconstruct the 6,997 by 150 feet (2,133 x 46m) runway

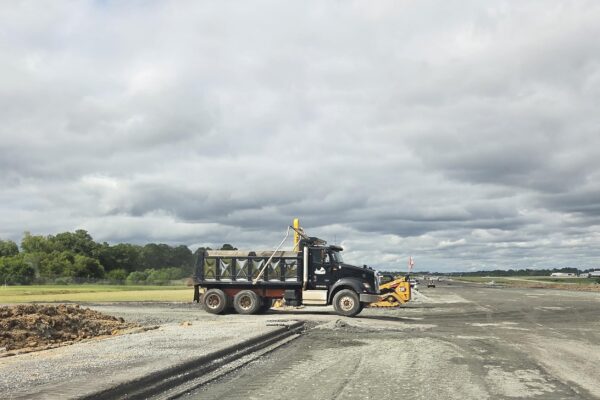

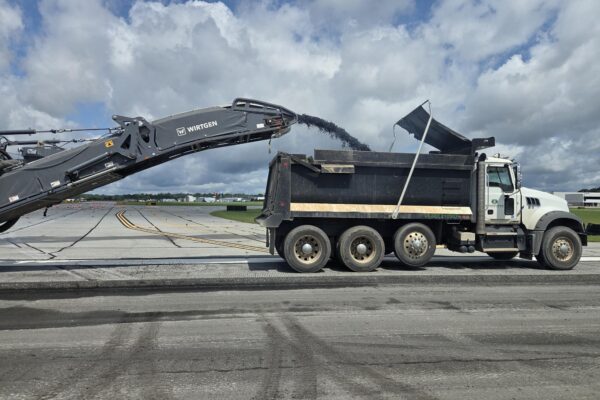

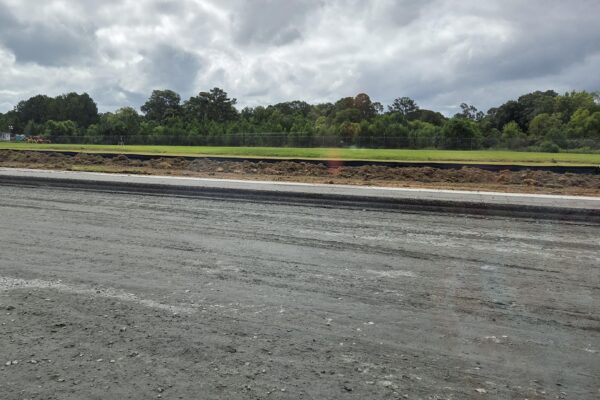

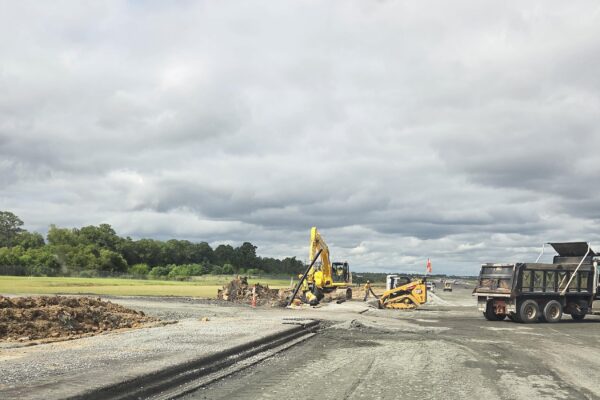

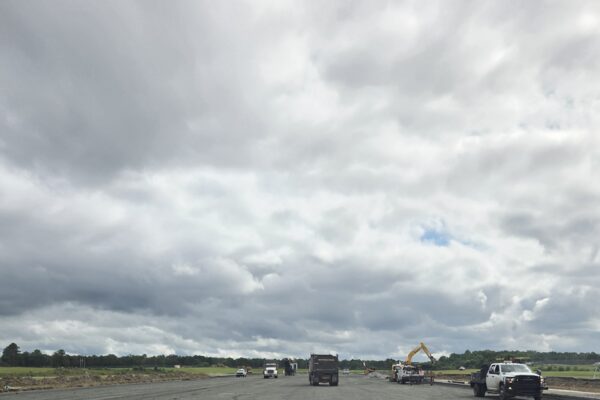

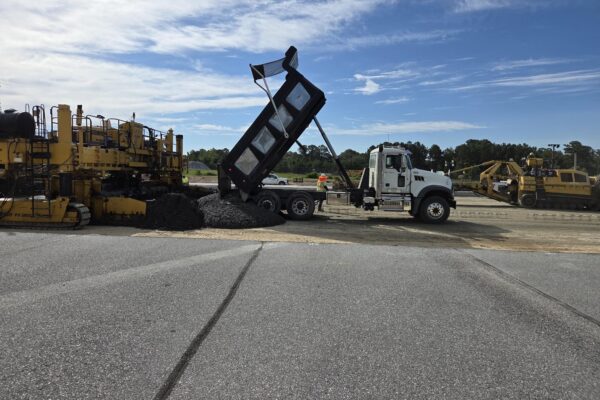

• Removal of all asphalt and base.

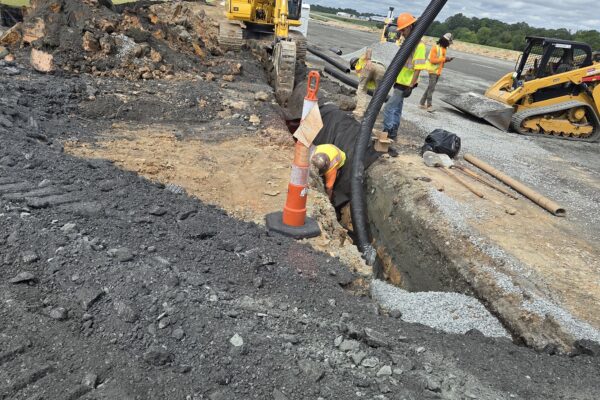

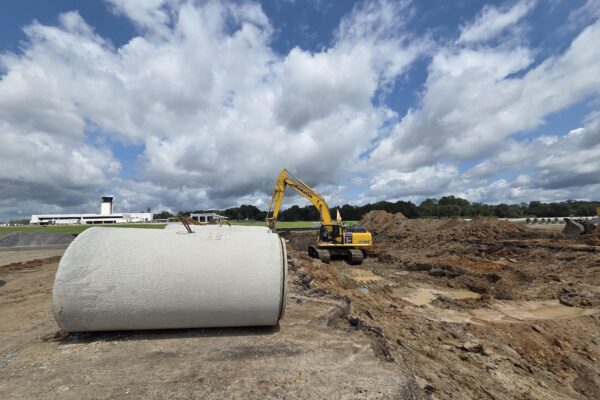

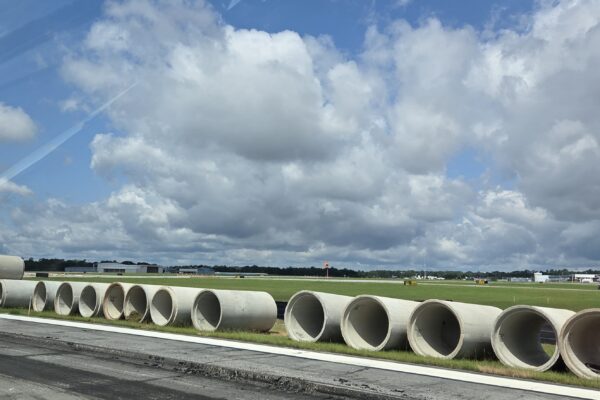

• Replacement of two storm drains that run horizontally underneath the runway.

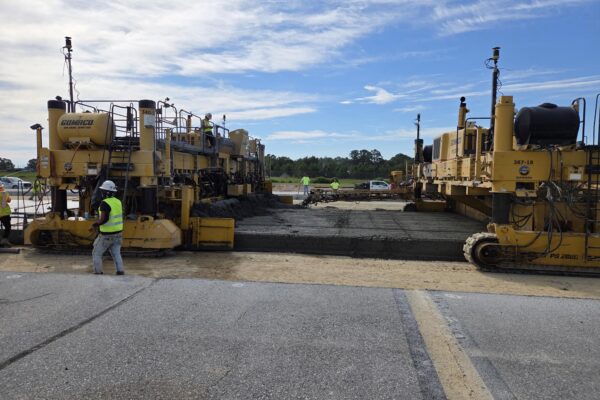

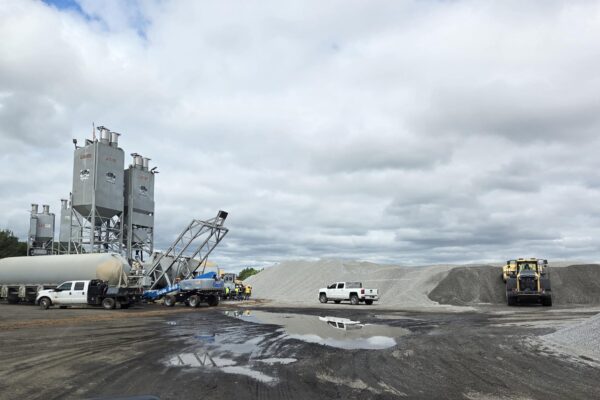

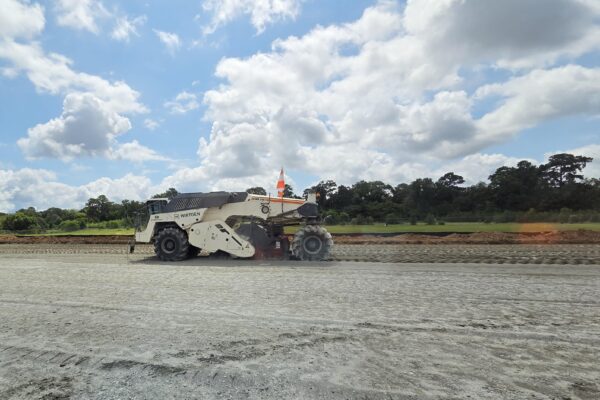

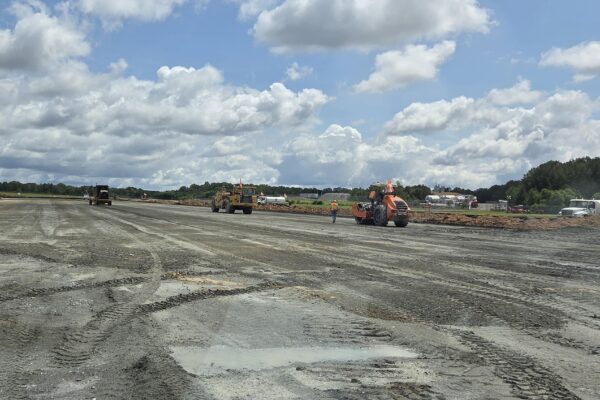

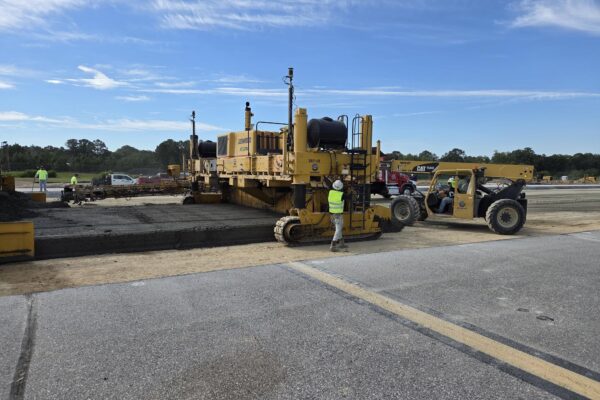

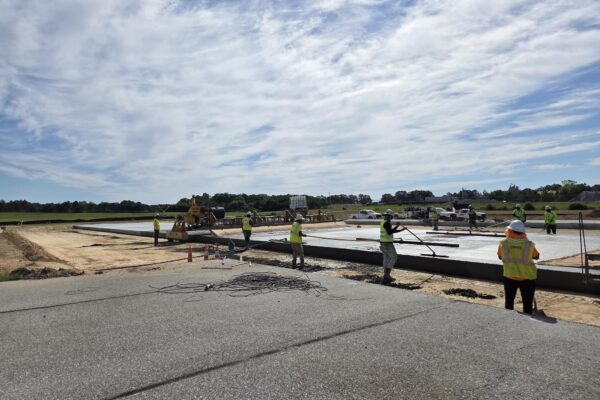

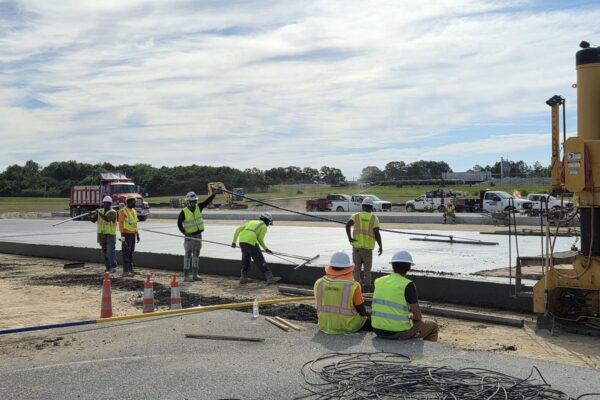

• Reconstruct the runway gravel base and relay the runaway using concrete.
• Installation of a longitudinal drainage system along the sides of the runway.

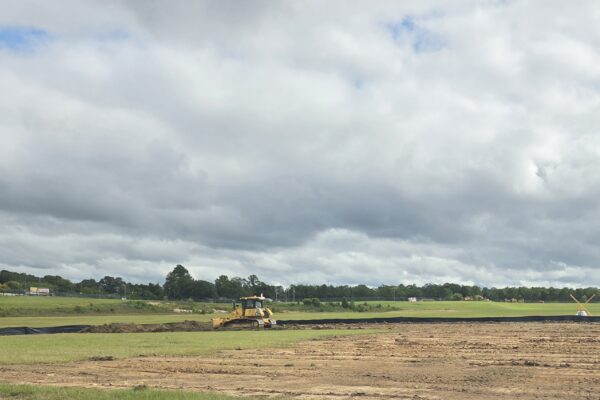

• Installation of a blast pad on the 24 end of runway.
• Installation of new runway lighting system.
• Grading to adjacent runway safety areas.
The average lifespan of a runway is 40 years. Runway 6-24 has exceeded that lifespan. As a result, a full reconstruction is necessary to ensure the safety, reliability, and long-term functionality of the runway.
The runway project initially had an earlier anticipated start date; however, based on recommendations from our airline partners, the Department of Transportation, the Federal Aviation Administration, and other community and project stakeholders, it was determined that an August 2025 start would be the most suitable option to minimize disruption.
The airport prioritizes safety and has diligently maintained runway 6-24 over its useful life through various projects, including resurfacing (remove grading) and crack sealing. The runway undergoes annual inspections by Federal Aviation Administration (FAA), consistently meeting required standards. Additionally, airport maintenance continuously monitors cracks, schedules routine preventative maintenance, rubber removal, and the repainting of the runway markings, which has allowed us to extend the runway’s lifespan. However, a full reconstruction is now necessary to ensure continued safety, efficiency, and long-term operational reliability.
Construction is scheduled to begin August 5, 2025 and is estimated to last through November 27, 2025.
The airport will remain open during this time. Only the commercial runway will be temporarily closed, with the intersection of runways 6-24 and 13-31 both closing for 3-4 weeks; the terminal will continue to function, and rental car services will still be available, as well as concessions for food and beverages. Additionally, Runway 13-31 will remain open to accommodate general aviation traffic except for the days accounted for the intersection.
Delta Air Lines has removed the ability to book commercial flights during the reconstruction phase. As a result, no commercial service will operate from August 5th through November 27th. However, passengers can still purchase tickets for travel on dates prior to August 5th and after November 27th, 2025.
If you have booked a flight departing from CSG between August 5th and November 27th, 2025, please contact Delta Customer Service at 1-800-221-1212 for assistance with rebooking your flight, refund inquires, or any additional support you may need.
Yes, rental car agencies Alamo, Avis, Budget, Enterprise, Hertz, and National will remain operational during the runway closure and will continue to operate during their normal business hours. Please check with each rental car agency directly for their specific hours of operation.
CSG runway 6-24 project plays a critical role in shaping the social and economic landscape of our community. However, during the reconstruction of the runway, we recognize that safety, infrastructure, air quality, and noise pollution are significant environmental concerns. We are committed to exercising due diligence throughout the project to minimize these impacts and maintain them at the lowest possible levels.
There are three easy ways to stay informed about the Runway 6-24 reconstruction project:
Delta Air Lines remains a committed partner of CSG and has maintained ongoing communication with the airport throughout the planning & implementation of the Runway 6-24 reconstruction project. Delta is working closely with us to ensure that service will resume promptly once the project is completed.
